E6 - AZ BERMAN DRIVE AND STOCK ROAD, MITCHELLS PLAIN
Construction Work Package E6
Areas affected: Mitchells Plain
Start date: September 2023
End date: September 2026
How it will affect you
Construction is planned in phases from September 2023 for approximately 3 years. Road works will be limited to 09:00 - 15:00 on weekdays to avoid peak traffic periods. Traffic will be accommodated using temporary detours and walkways for pedestrians while access to properties and businesses will be maintained. Work will still impact traffic and cause delays. Motorists are urged to consider public transport, ride-sharing and lift club options. The City realises the inconvenience involved and appreciates the patience of everyone affected.
Job Opportunities
Although the bulk of construction requires highly specialised skills, the project includes some opportunities to employ local labour and to source goods and services from local subcontractors. Residents who are interested are encouraged to confirm that they are registered and their details up to date at the local Subcouncil. Residents who are not yet registered can look out for new registration drives in each area before work starts.

Information Days
Beacon Valley Community Centre, 6 March 2025
Living Stones Assembly of God, 5 March 2025
37 Ntloyiya Road, New Rest, Philippi, 20 June 2024
Subcouncil 17 Chambers, 12 June 2024
Heinz Park Community Hall, 22 February 2024
Lobelia Community Hall, 21 February 2024
Lobelia Community Hall, 23 November 2023
E6 Project Updates
Traffic diversions - June 2024
Traffic diversions - August 2024

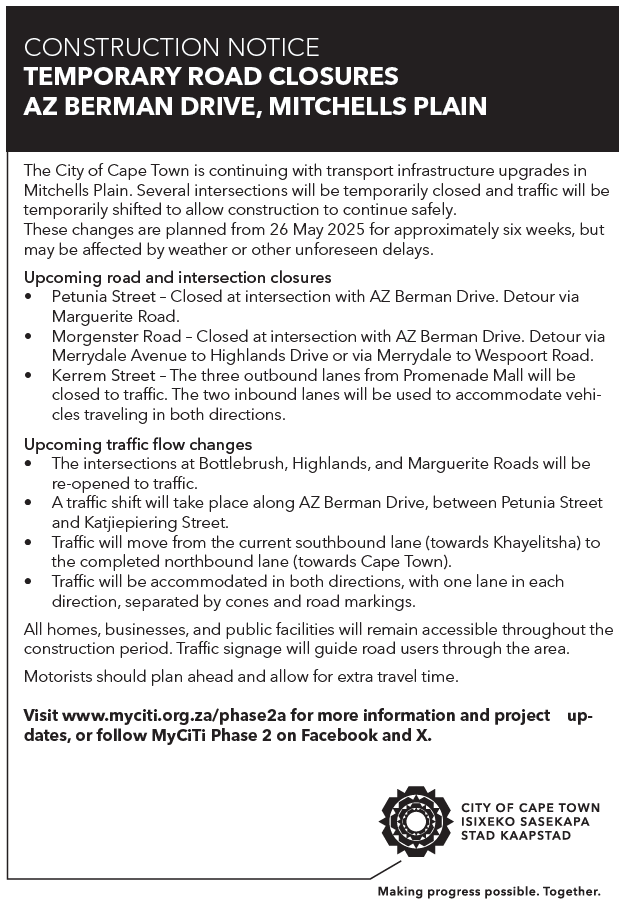

Leaflet: Road Closures and Detours
